Structured Cabling Labeling Scheme: Cables, Ports, Outlets and Test Records

Create a stable administration system that connects physical labels, floor plans, cable schedules, patch-panel ports, switch ports, test files, and moves or changes.

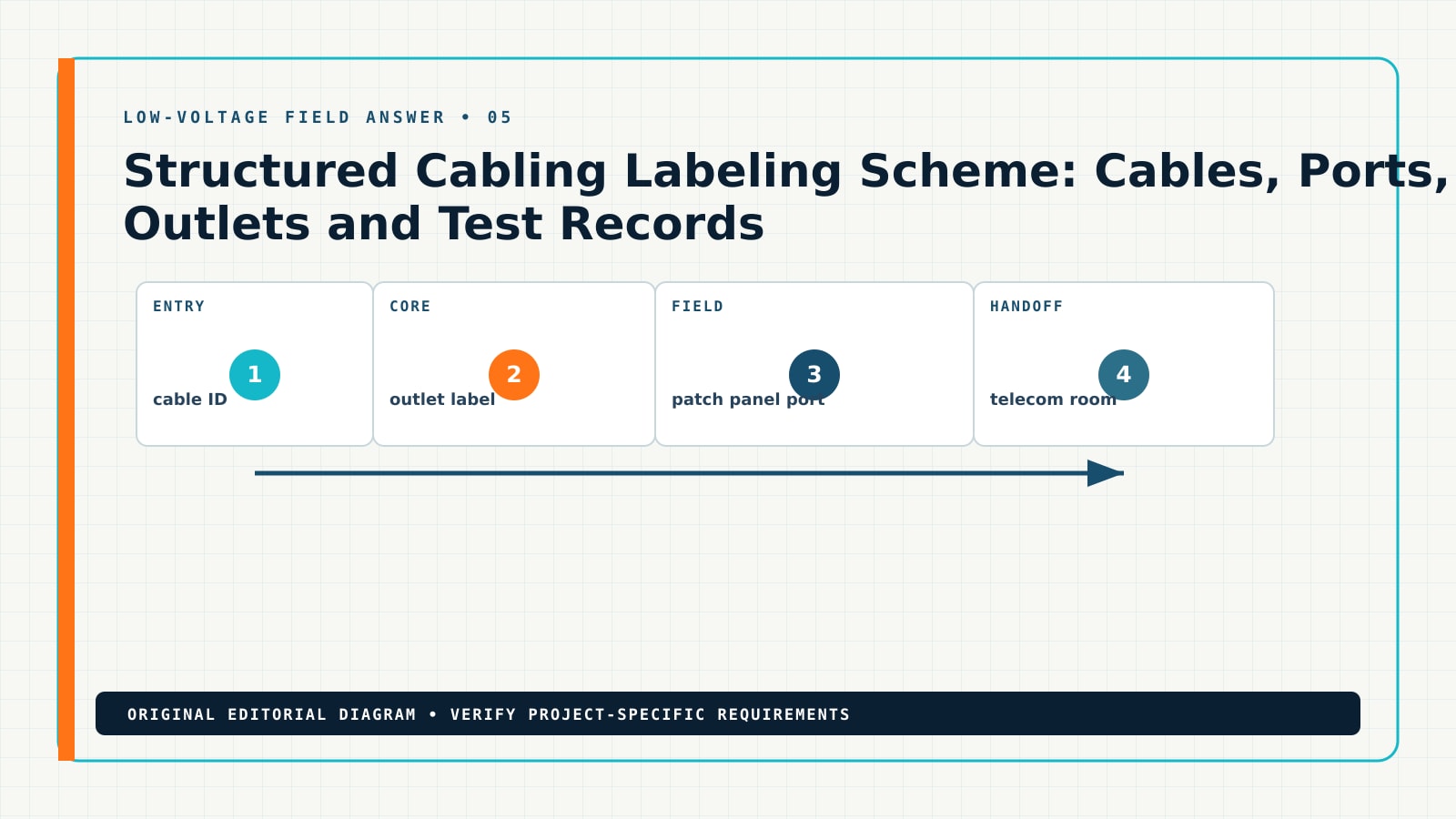

Diagram showing the documented workflow for structured cabling labeling scheme, including cable ID, outlet label, patch panel port, telecom room

Structured Cabling field answer

Structured Cabling Labeling Scheme: Cables, Ports, Outlets and Test Records

Create a stable administration system that connects physical labels, floor plans, cable schedules, patch-panel ports, switch ports, test files, and moves or changes. This contractor-focused guide answers the search directly, shows the project records that should carry the decision, and explains how to move from preliminary intent to a traceable proposal and field handoff.

Answer-first guidanceWorked field scenarioTraceable contractor record
Diagram showing the documented workflow for structured cabling labeling scheme, including cable ID, outlet label, patch panel port, telecom room
A contractor-focused visual map for structured cabling labeling scheme.

structured cabling labeling scheme: the practical answer

Create a stable administration system that connects physical labels, floor plans, cable schedules, patch-panel ports, switch ports, test files, and moves or changes. A useful answer does not begin with a product count or a decorative symbol. It begins with the outcome the customer or operator needs, the field evidence available, the system relationships that produce the outcome, and the constraints that could change the work.

Build the record so another qualified person can audit it. Every key location, endpoint, cable, pathway, port, controller, rack, power source, network service, software dependency and test should have an identity appropriate to the project. Every important value should show whether it is verified, selected, calculated, assumed, excluded or awaiting another party. That distinction prevents early planning information from becoming an accidental promise.

For structured cabling, keep the focused question connected to the broader system. Build traceable outlet, cable, pathway, patching, rack, backbone, labeling, testing, quantity, and proposal records from one controlled plan. The immediate answer may sit on one page, but it can affect schedules, diagrams, infrastructure, labor, licensing, customer responsibilities, commissioning and closeout. A professional workflow exposes those consequences before pricing is locked.

Six inputs that make the answer defensible

The table is an intake map. Replace generic phrases with project facts and cite their origin. When a fact is unavailable, use a field-verification item, allowance, alternate, prerequisite or exclusion; do not silently invent precision.

Input Decision to close Primary record Status example
cable ID Choose the administration scope and owner naming standard before installation Outlet and device floor plan authority or design-team decision
outlet label Define identifiers for spaces, racks, panels, ports, outlets, cables, backbones, pathways, and grounds Horizontal cable schedule explicit allowance or exclusion
patch panel port Keep the visible label concise and place descriptive attributes in the schedule Rack and patch-panel elevation verified field condition
telecom room Use the same identifier in drawings, test instruments, file names, punch lists, and closeout Backbone/riser diagram manufacturer-confirmed requirement
test report Define durable label material, placement, printing, replacement, and spare-port rules Label and test matrix customer-approved choice
as-built record Treat every move, add, or change as incomplete until the physical and digital records agree BOM and labor quantity basis qualified calculation input

The primary record is not the only record. The design succeeds when the same identity can be traced from location to schedule, relationship diagram, quantity, proposal, field change and acceptance evidence. A change to one input should produce a visible impact review rather than an unexplained revision.

Build the answer into the drawing and project record

1. Baseline evidence: Choose the administration scope and owner naming standard before installation

Capture the evidence. Tie this choice to Work-area outlet locations, types, quantities, mounting, furniture, floor-box, and specialty endpoint conditions. Name the source, accountable party, observation date, issue revision and its status as a authority or design-team decision. A plausible value is not a verified value.

Place the decision. Show location and intent on the plan, repeated attributes in the schedule, and connection logic in the WA-101 outlet. Keep calculations auditable and carry commercial boundaries into the responsibility and proposal records. One stable identity should join those views.

Challenge the result. Coordinate Architectural room names, furniture, millwork, floor boxes, ceilings, walls, and accessibility. Ask an estimator to trace the quantity, an installer to find the field instruction, and a reviewer to identify the acceptance evidence. Record every downstream document that changes with this input.

2. Plan and schedule: Define identifiers for spaces, racks, panels, ports, outlets, cables, backbones, pathways, and grounds

Capture the evidence. Tie this choice to Horizontal cable IDs, media, origin, destination, pathway, length basis, service loop, termination, and status. Name the source, accountable party, observation date, issue revision and its status as a explicit allowance or exclusion. A plausible value is not a verified value.

Place the decision. Show location and intent on the plan, repeated attributes in the schedule, and connection logic in the Cable C-101. Keep calculations auditable and carry commercial boundaries into the responsibility and proposal records. One stable identity should join those views.

Challenge the result. Coordinate Pathway type, fill assumptions, sleeves, firestopping, supports, penetrations, separation, and responsible trade. Ask an estimator to trace the quantity, an installer to find the field instruction, and a reviewer to identify the acceptance evidence. Record every downstream document that changes with this input.

3. System relationship: Keep the visible label concise and place descriptive attributes in the schedule

Capture the evidence. Tie this choice to Telecommunications rooms, enclosures, racks, patch panels, cable management, power, grounding, cooling, and access. Name the source, accountable party, observation date, issue revision and its status as a verified field condition. A plausible value is not a verified value.

Place the decision. Show location and intent on the plan, repeated attributes in the schedule, and connection logic in the PP-1 port 01. Keep calculations auditable and carry commercial boundaries into the responsibility and proposal records. One stable identity should join those views.

Challenge the result. Coordinate Telecommunications-room dimensions, backboards, racks, grounding, electrical power, HVAC, security, and working clearance. Ask an estimator to trace the quantity, an installer to find the field instruction, and a reviewer to identify the acceptance evidence. Record every downstream document that changes with this input.

4. Shared dependency: Use the same identifier in drawings, test instruments, file names, punch lists, and closeout

Capture the evidence. Tie this choice to Backbone routes, media, strands or pairs, splice/termination points, diversity, capacity, and building entrances. Name the source, accountable party, observation date, issue revision and its status as a manufacturer-confirmed requirement. A plausible value is not a verified value.

Place the decision. Show location and intent on the plan, repeated attributes in the schedule, and connection logic in the Rack TR-1. Keep calculations auditable and carry commercial boundaries into the responsibility and proposal records. One stable identity should join those views.

Challenge the result. Coordinate Network equipment, patching, port allocation, owner-furnished hardware, ISP/demarcation, and activation responsibility. Ask an estimator to trace the quantity, an installer to find the field instruction, and a reviewer to identify the acceptance evidence. Record every downstream document that changes with this input.

5. Commercial consequence: Define durable label material, placement, printing, replacement, and spare-port rules

Capture the evidence. Tie this choice to Administration scheme for room, rack, panel, port, outlet, cable, backbone, and test identifiers. Name the source, accountable party, observation date, issue revision and its status as a customer-approved choice. A plausible value is not a verified value.

Place the decision. Show location and intent on the plan, repeated attributes in the schedule, and connection logic in the Backbone to MDF. Keep calculations auditable and carry commercial boundaries into the responsibility and proposal records. One stable identity should join those views.

Challenge the result. Coordinate Cable-length uncertainty, inaccessible routes, remodel conditions, demolition, reuse, temporary service, and phasing. Ask an estimator to trace the quantity, an installer to find the field instruction, and a reviewer to identify the acceptance evidence. Record every downstream document that changes with this input.

6. Acceptance evidence: Treat every move, add, or change as incomplete until the physical and digital records agree

Capture the evidence. Tie this choice to Testing, certification, closeout, warranty, spare capacity, owner standards, and exclusions. Name the source, accountable party, observation date, issue revision and its status as a qualified calculation input. A plausible value is not a verified value.

Place the decision. Show location and intent on the plan, repeated attributes in the schedule, and connection logic in the WA-101 outlet. Keep calculations auditable and carry commercial boundaries into the responsibility and proposal records. One stable identity should join those views.

Challenge the result. Coordinate Testing limits, documentation format, warranty program, approved products, labeling convention, and acceptance. Ask an estimator to trace the quantity, an installer to find the field instruction, and a reviewer to identify the acceptance evidence. Record every downstream document that changes with this input.

Four-stage contractor workflow

Use progressive detail. A sales-stage plan may document purpose, location and open assumptions. A construction or regulated submittal may require product-specific calculations, licensed design, manufacturer documents and authority review. Label the stage honestly so the reader understands what may be relied upon.

  1. Survey. Verify spaces, work areas, equipment locations, pathways, service entrance, and customer standards. For structured cabling labeling scheme, preserve the location, design intent, status, owner and next field check so the drawing communicates a controlled decision rather than an anonymous symbol.
  2. Lay out. Assign outlet and cable identities on the floor plan before producing quantities. For structured cabling labeling scheme, preserve the location, design intent, status, owner and next field check so the drawing communicates a controlled decision rather than an anonymous symbol.
  3. Coordinate. Map horizontal and backbone links through patch panels, racks, rooms, grounding, power, and network ownership. For structured cabling labeling scheme, preserve the location, design intent, status, owner and next field check so the drawing communicates a controlled decision rather than an anonymous symbol.
  4. Issue. Reconcile labels, tests, as-builts, BOM, labor, allowances, and proposal scope against the issued revision. For structured cabling labeling scheme, preserve the location, design intent, status, owner and next field check so the drawing communicates a controlled decision rather than an anonymous symbol.

What must remain synchronized

The controlling baseline, Outlet and device floor plan, Horizontal cable schedule, Rack and patch-panel elevation, Backbone/riser diagram, quantity basis, proposal scope, field copy, change log and closeout record should describe the same issued decision. If they do not, stop and reconcile them before procurement or installation.

Worked field scenario: two-floor office build-out

Starting condition. floor plan numbers, panel labels, and tester file names use unrelated conventions.

Contractor response. The team applies the six decision groups above, assigns stable identities, marks unknowns, connects the focused answer to Testing limits, documentation format, warranty program, approved products, labeling convention, and acceptance, and issues the affected plan, schedule, relationship and quantity records together.

Outcome. one hierarchical identity allows technicians to trace any outlet in both directions without tone-and-probe guesswork. The customer can see what is included, what another party must provide, what remains to be verified, and how acceptance will be demonstrated.

Example traceability chain

  1. Outcome: state the operating result in customer language.
  2. Evidence: attach the measurement, photograph, survey note, approved selection, product data or authority direction that controls the decision.
  3. Design: show the location, identity, attributes and system relationship on the appropriate documents.
  4. Quantity: connect equipment, accessories, cable, pathway, labor, licensing, configuration and testing to the issued revision.
  5. Acceptance: define the observation, measurement, function, report or approval that closes the requirement.

Common failure modes and how to correct them

Failure Why it matters Corrective action
the input was assumed but presented as verified It breaks traceability for cable ID and can move risk into estimating, installation or acceptance without an owner. Choose the administration scope and owner naming standard before installation; then reissue affected records under one revision.
the floor plan and schedule use different identities It breaks traceability for outlet label and can move risk into estimating, installation or acceptance without an owner. Define identifiers for spaces, racks, panels, ports, outlets, cables, backbones, pathways, and grounds; then reissue affected records under one revision.
a shared pathway, network, power or trade dependency has no owner It breaks traceability for patch panel port and can move risk into estimating, installation or acceptance without an owner. Keep the visible label concise and place descriptive attributes in the schedule; then reissue affected records under one revision.
the estimate uses a quantity that cannot be traced to an issued drawing It breaks traceability for telecom room and can move risk into estimating, installation or acceptance without an owner. Use the same identifier in drawings, test instruments, file names, punch lists, and closeout; then reissue affected records under one revision.
a product-specific limit was replaced with a generic rule of thumb It breaks traceability for test report and can move risk into estimating, installation or acceptance without an owner. Define durable label material, placement, printing, replacement, and spare-port rules; then reissue affected records under one revision.
the closeout test proves installation but not the required operating outcome It breaks traceability for as-built record and can move risk into estimating, installation or acceptance without an owner. Treat every move, add, or change as incomplete until the physical and digital records agree; then reissue affected records under one revision.

Correction is not merely adding another note. Identify the controlling source, update the proper document, propagate the change to dependent quantities and scope, notify responsible parties, and preserve what changed. That is what turns a technically correct answer into a reliable contractor workflow.

Pre-proposal audit checklist

  • cable ID: find its location and identity on the controlling record, confirm who approved it, and trace the same intent through schedule, system relationship, quantity, proposal and acceptance evidence.
  • outlet label: find its location and identity on the controlling record, confirm who approved it, and trace the same intent through schedule, system relationship, quantity, proposal and acceptance evidence.
  • patch panel port: find its location and identity on the controlling record, confirm who approved it, and trace the same intent through schedule, system relationship, quantity, proposal and acceptance evidence.
  • telecom room: find its location and identity on the controlling record, confirm who approved it, and trace the same intent through schedule, system relationship, quantity, proposal and acceptance evidence.
  • test report: find its location and identity on the controlling record, confirm who approved it, and trace the same intent through schedule, system relationship, quantity, proposal and acceptance evidence.
  • as-built record: find its location and identity on the controlling record, confirm who approved it, and trace the same intent through schedule, system relationship, quantity, proposal and acceptance evidence.
  • Shared infrastructure: name the owner of rooms, racks, pathways, network, power, UPS, grounding, firestopping, accounts, licenses and support.
  • Revision: confirm the customer-facing proposal cites the same drawing and schedule revision used for quantities.
  • Boundary: distinguish contractor coordination from engineering, permitting, code review, cybersecurity, privacy, accessibility and authority approval.
  • Acceptance: describe what will be observed, measured, demonstrated, documented and approved—not only that equipment will be installed.

If any answer is missing, assign it. A named open item is manageable; an invisible assumption is not. Use alternates when the customer must choose between documented approaches, allowances when quantity or condition cannot yet be verified, and exclusions only when the boundary is explicit and commercially understood.

Turn the answer into customer-readable scope

A professional proposal should cite the project and revision, summarize the outcome, list included deliverables, explain major quantities, identify infrastructure and third-party dependencies, state assumptions, distinguish owner-furnished items, and define tests and closeout. It should not paste this article or bury technical uncertainty in fine print.

Write inclusions around work products: survey verification, plan updates, equipment and accessory schedules, cable and pathway scope, configuration, programming, testing, training, as-builts and support. Write exclusions around clear responsibility boundaries. If a dependency could stop the system from working—such as internet, VLANs, door hardware, power, structure, permits or manufacturer services—place it near the related scope and assign an owner.

Continue through the Structured Cabling topic cluster

This page answers one focused question. Use the connected resources to move from the immediate answer into the complete design, documentation and commercial workflow.

Authoritative references and verification boundary

Use current editions, adopted requirements, approved submittals and exact manufacturer instructions for the actual project. The sources below provide useful primary context, but no public article can decide project-specific licensing, engineering responsibility, code compliance, cybersecurity, privacy, accessibility, product compatibility or authority acceptance.

  1. TIA Administration Standard Announcement — cabling administration and identification context.
  2. TIA Standards — telecommunications standards development.
  3. FOA Fiber Optic Standards — cabling and fiber standards orientation.

Frequently asked questions

What is the fastest reliable way to start structured cabling labeling scheme?

Start by writing the operating outcome and collecting the evidence that controls it. Build the IDs and schedule before drawing anonymous symbols. Mark every important input as verified, selected, assumed, excluded or assigned, then connect it to a plan, relationship diagram, quantity and acceptance check.

What should be included in the project record?

At minimum, preserve the verified baseline, stable identities, the six decision groups on this page, shared infrastructure and responsibilities, product-specific requirements, quantity basis, revision status, test evidence and closeout updates. The exact set depends on the contract, system risk and responsible designer.

Can a generic rule of thumb replace manufacturer or code requirements?

No. Rules of thumb may help compare early options, but final decisions must use the adopted requirements, approved equipment data, actual route or geometry, responsible professional review and authority process that apply to the project.

How should this answer affect a proposal?

Turn unresolved facts into named qualifications rather than hidden risk. Include the controlling drawing revision, traceable quantities, responsibilities, prerequisites, allowances, alternatives, exclusions, testing and acceptance. When the design changes, issue the quantity and commercial impact together.

What should I read next?

Open Telecom Room Rack Layout: Patch Panels, Switches, Power and Cable Management for the paired industry problem, then use the canonical Structured Cabling workflow page to connect the answer to a complete plan, proposal and field handoff.
