Building Automation Points List: I/O, Objects, Alarms, Trends and Acceptance

Create a points schedule that connects each sensor, command, status, setpoint, alarm, trend, unit, range, controller, graphic, sequence, and commissioning test.

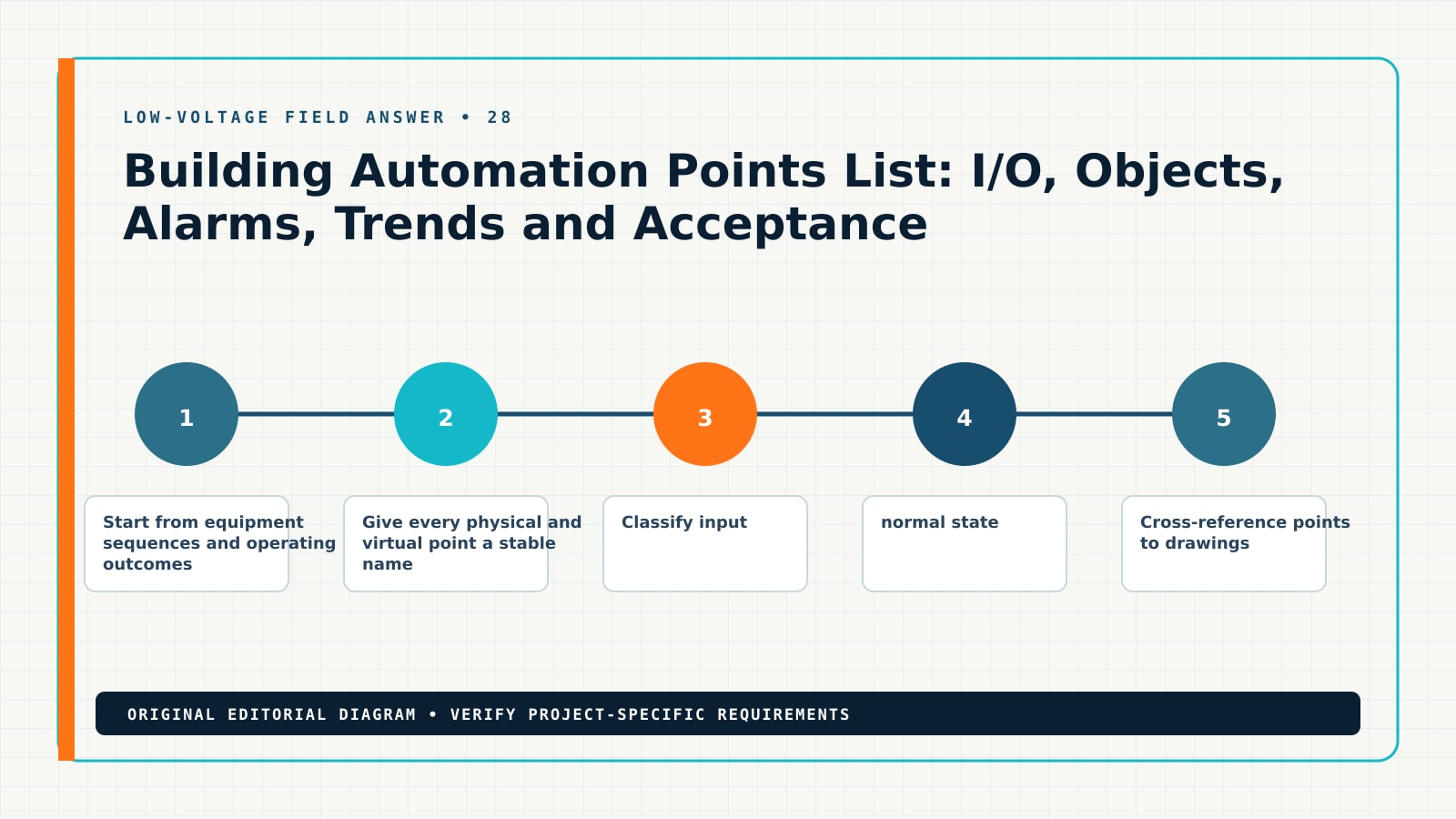

Diagram showing the documented workflow for building automation points list, including BAS points list, analog input, binary output, alarm priority

Building Automation & Controls field answer

Building Automation Points List: I/O, Objects, Alarms, Trends and Acceptance

Create a points schedule that connects each sensor, command, status, setpoint, alarm, trend, unit, range, controller, graphic, sequence, and commissioning test. This contractor-focused guide answers the search directly, shows the project records that should carry the decision, and explains how to move from preliminary intent to a traceable proposal and field handoff.

Answer-first guidanceWorked field scenarioTraceable contractor record
Diagram showing the documented workflow for building automation points list, including BAS points list, analog input, binary output, alarm priority
A contractor-focused visual map for building automation points list.

building automation points list: the practical answer

Create a points schedule that connects each sensor, command, status, setpoint, alarm, trend, unit, range, controller, graphic, sequence, and commissioning test. A useful answer does not begin with a product count or a decorative symbol. It begins with the outcome the customer or operator needs, the field evidence available, the system relationships that produce the outcome, and the constraints that could change the work.

Build the record so another qualified person can audit it. Every key location, endpoint, cable, pathway, port, controller, rack, power source, network service, software dependency and test should have an identity appropriate to the project. Every important value should show whether it is verified, selected, calculated, assumed, excluded or awaiting another party. That distinction prevents early planning information from becoming an accidental promise.

For building automation & controls, keep the focused question connected to the broader system. Translate sequences of operation into controller, sensor, actuator, panel, network, integration, point-list, power, cable, commissioning, and proposal records. The immediate answer may sit on one page, but it can affect schedules, diagrams, infrastructure, labor, licensing, customer responsibilities, commissioning and closeout. A professional workflow exposes those consequences before pricing is locked.

Six inputs that make the answer defensible

The table is an intake map. Replace generic phrases with project facts and cite their origin. When a fact is unavailable, use a field-verification item, allowance, alternate, prerequisite or exclusion; do not silently invent precision.

Input Decision to close Primary record Status example
BAS points list Start from equipment sequences and operating outcomes, not controller capacity Controls device floor plan qualified calculation input
analog input Give every physical and virtual point a stable name, description, unit, range, source, and controller Controller and panel schedule authority or design-team decision
binary output Classify input, output, value, command, status, setpoint, calculated, alarm, and trend behavior Network/topology diagram explicit allowance or exclusion
alarm priority Record normal state, fail state, alarm threshold, delay, priority, acknowledgement, and notification Point list and I/O matrix verified field condition
trend log Cross-reference points to drawings, panels, control diagrams, graphics, network objects, and test scripts Sequence-to-device crosswalk manufacturer-confirmed requirement
sequence of operation Reconcile installed devices, database export, graphics, sequences, trends, commissioning, and closeout Functional performance test plan customer-approved choice

The primary record is not the only record. The design succeeds when the same identity can be traced from location to schedule, relationship diagram, quantity, proposal, field change and acceptance evidence. A change to one input should produce a visible impact review rather than an unexplained revision.

Build the answer into the drawing and project record

1. Baseline evidence: Start from equipment sequences and operating outcomes, not controller capacity

Establish the basis. Start with HVAC, lighting, metering, energy, indoor-air-quality, scheduling, alarm, monitoring, and specialty control objectives and preserve the governing source. Record who supplied it, when it was checked, which revision it controls, and why it qualifies as a qualified calculation input. Separate measured facts from selections and allowances.

Make it reproducible. Put the input beside its units, route, device or endpoint identity. Cross-reference the result to Room sensor RS-01, the applicable schedule, plan callout, quantity takeoff and scope note so another qualified person can repeat the check.

Test sensitivity and ownership. Review Mechanical schedules, equipment selections, control diagrams, sequences, balancing, safeties, warranties, and manufacturer interfaces. Identify the limit, margin and failure condition; then assign who must recheck the result if distance, quantity, equipment, topology, operating mode or project criteria change.

2. Plan and schedule: Give every physical and virtual point a stable name, description, unit, range, source, and controller

Establish the basis. Start with Controllers, sensors, transmitters, switches, actuators, relays, drives, gateways, panels, and operator interfaces and preserve the governing source. Record who supplied it, when it was checked, which revision it controls, and why it qualifies as a authority or design-team decision. Separate measured facts from selections and allowances.

Make it reproducible. Put the input beside its units, route, device or endpoint identity. Cross-reference the result to Equipment controller, the applicable schedule, plan callout, quantity takeoff and scope note so another qualified person can repeat the check.

Test sensitivity and ownership. Review Electrical power, starters, drives, circuits, panels, emergency power, transformers, grounding, and disconnect responsibility. Identify the limit, margin and failure condition; then assign who must recheck the result if distance, quantity, equipment, topology, operating mode or project criteria change.

3. System relationship: Classify input, output, value, command, status, setpoint, calculated, alarm, and trend behavior

Establish the basis. Start with Analog, binary, calculated, command, alarm, trend, schedule, setpoint, occupancy, override, and diagnostic points and preserve the governing source. Record who supplied it, when it was checked, which revision it controls, and why it qualifies as a explicit allowance or exclusion. Separate measured facts from selections and allowances.

Make it reproducible. Put the input beside its units, route, device or endpoint identity. Cross-reference the result to Actuator output, the applicable schedule, plan callout, quantity takeoff and scope note so another qualified person can repeat the check.

Test sensitivity and ownership. Review IT networks, addressing, VLANs, firewalls, servers, cloud services, identity, certificates, remote access, backups, and monitoring. Identify the limit, margin and failure condition; then assign who must recheck the result if distance, quantity, equipment, topology, operating mode or project criteria change.

4. Shared dependency: Record normal state, fail state, alarm threshold, delay, priority, acknowledgement, and notification

Establish the basis. Start with Control panels, transformers, circuits, disconnects, power supplies, UPS, grounding, enclosures, and environmental requirements and preserve the governing source. Record who supplied it, when it was checked, which revision it controls, and why it qualifies as a verified field condition. Separate measured facts from selections and allowances.

Make it reproducible. Put the input beside its units, route, device or endpoint identity. Cross-reference the result to BAS network trunk, the applicable schedule, plan callout, quantity takeoff and scope note so another qualified person can repeat the check.

Test sensitivity and ownership. Review Architectural spaces, sensor locations, accessibility, public interfaces, ceilings, shafts, equipment rooms, and finish coordination. Identify the limit, margin and failure condition; then assign who must recheck the result if distance, quantity, equipment, topology, operating mode or project criteria change.

5. Commercial consequence: Cross-reference points to drawings, panels, control diagrams, graphics, network objects, and test scripts

Establish the basis. Start with IP and field-bus networks, addressing, topology, segmentation, gateways, protocols, licenses, remote access, and cybersecurity and preserve the governing source. Record who supplied it, when it was checked, which revision it controls, and why it qualifies as a manufacturer-confirmed requirement. Separate measured facts from selections and allowances.

Make it reproducible. Put the input beside its units, route, device or endpoint identity. Cross-reference the result to Supervisory front end, the applicable schedule, plan callout, quantity takeoff and scope note so another qualified person can repeat the check.

Test sensitivity and ownership. Review Other controls trades including lighting, fire alarm, security, metering, elevators, generators, refrigeration, and specialty systems. Identify the limit, margin and failure condition; then assign who must recheck the result if distance, quantity, equipment, topology, operating mode or project criteria change.

6. Acceptance evidence: Reconcile installed devices, database export, graphics, sequences, trends, commissioning, and closeout

Establish the basis. Start with Sequences, graphics, databases, integration, commissioning, functional tests, training, backups, as-builts, and support and preserve the governing source. Record who supplied it, when it was checked, which revision it controls, and why it qualifies as a customer-approved choice. Separate measured facts from selections and allowances.

Make it reproducible. Put the input beside its units, route, device or endpoint identity. Cross-reference the result to Room sensor RS-01, the applicable schedule, plan callout, quantity takeoff and scope note so another qualified person can repeat the check.

Test sensitivity and ownership. Review Owner standards for naming, graphics, alarming, trending, permissions, change control, commissioning, documentation, and training. Identify the limit, margin and failure condition; then assign who must recheck the result if distance, quantity, equipment, topology, operating mode or project criteria change.

Four-stage contractor workflow

Use progressive detail. A sales-stage plan may document purpose, location and open assumptions. A construction or regulated submittal may require product-specific calculations, licensed design, manufacturer documents and authority review. Label the stage honestly so the reader understands what may be relied upon.

  1. Collect. Confirm owner outcomes, systems, equipment, operating sequences, control boundaries, alarm priorities, trends, schedules, and integration responsibilities. For building automation points list, retain the input source, units, formula or test method, margin, pass/fail criterion, responsible party and trigger for recalculation.
  2. Calculate. Map controllers, sensors, actuators, interfaces, panels, network segments, power sources, and equipment relationships. For building automation points list, retain the input source, units, formula or test method, margin, pass/fail criterion, responsible party and trigger for recalculation.
  3. Stress-check. Build point lists, addressing, naming, graphics, sequences, alarms, trends, access, cybersecurity, and front-end requirements. For building automation points list, retain the input source, units, formula or test method, margin, pass/fail criterion, responsible party and trigger for recalculation.
  4. Record. Reconcile devices, panels, cable, programming, graphics, integration, testing, balancing, training, closeout, and scope. For building automation points list, retain the input source, units, formula or test method, margin, pass/fail criterion, responsible party and trigger for recalculation.

What must remain synchronized

The controlling baseline, Controls device floor plan, Controller and panel schedule, Network/topology diagram, Point list and I/O matrix, quantity basis, proposal scope, field copy, change log and closeout record should describe the same issued decision. If they do not, stop and reconcile them before procurement or installation.

Worked field scenario: air-handling-unit controls replacement

Starting condition. the controller submittal lists I/O counts but not functional point behavior.

Contractor response. The team applies the six decision groups above, assigns stable identities, marks unknowns, connects the focused answer to Other controls trades including lighting, fire alarm, security, metering, elevators, generators, refrigeration, and specialty systems, and issues the affected plan, schedule, relationship and quantity records together.

Outcome. the points list becomes a review bridge among mechanical, controls, electrical, IT, and commissioning teams. The customer can see what is included, what another party must provide, what remains to be verified, and how acceptance will be demonstrated.

Example traceability chain

  1. Outcome: state the operating result in customer language.
  2. Evidence: attach the measurement, photograph, survey note, approved selection, product data or authority direction that controls the decision.
  3. Design: show the location, identity, attributes and system relationship on the appropriate documents.
  4. Quantity: connect equipment, accessories, cable, pathway, labor, licensing, configuration and testing to the issued revision.
  5. Acceptance: define the observation, measurement, function, report or approval that closes the requirement.

Common failure modes and how to correct them

Failure Why it matters Corrective action
the input was assumed but presented as verified It breaks traceability for BAS points list and can move risk into estimating, installation or acceptance without an owner. Start from equipment sequences and operating outcomes, not controller capacity; then reissue affected records under one revision.
the floor plan and schedule use different identities It breaks traceability for analog input and can move risk into estimating, installation or acceptance without an owner. Give every physical and virtual point a stable name, description, unit, range, source, and controller; then reissue affected records under one revision.
a shared pathway, network, power or trade dependency has no owner It breaks traceability for binary output and can move risk into estimating, installation or acceptance without an owner. Classify input, output, value, command, status, setpoint, calculated, alarm, and trend behavior; then reissue affected records under one revision.
the estimate uses a quantity that cannot be traced to an issued drawing It breaks traceability for alarm priority and can move risk into estimating, installation or acceptance without an owner. Record normal state, fail state, alarm threshold, delay, priority, acknowledgement, and notification; then reissue affected records under one revision.
a product-specific limit was replaced with a generic rule of thumb It breaks traceability for trend log and can move risk into estimating, installation or acceptance without an owner. Cross-reference points to drawings, panels, control diagrams, graphics, network objects, and test scripts; then reissue affected records under one revision.
the closeout test proves installation but not the required operating outcome It breaks traceability for sequence of operation and can move risk into estimating, installation or acceptance without an owner. Reconcile installed devices, database export, graphics, sequences, trends, commissioning, and closeout; then reissue affected records under one revision.

Correction is not merely adding another note. Identify the controlling source, update the proper document, propagate the change to dependent quantities and scope, notify responsible parties, and preserve what changed. That is what turns a technically correct answer into a reliable contractor workflow.

Pre-proposal audit checklist

  • BAS points list: verify the value, units and source; reproduce the check; compare it with the applicable limit; and trace its effect into equipment selection, quantities, proposal qualifications and test documentation.
  • analog input: verify the value, units and source; reproduce the check; compare it with the applicable limit; and trace its effect into equipment selection, quantities, proposal qualifications and test documentation.
  • binary output: verify the value, units and source; reproduce the check; compare it with the applicable limit; and trace its effect into equipment selection, quantities, proposal qualifications and test documentation.
  • alarm priority: verify the value, units and source; reproduce the check; compare it with the applicable limit; and trace its effect into equipment selection, quantities, proposal qualifications and test documentation.
  • trend log: verify the value, units and source; reproduce the check; compare it with the applicable limit; and trace its effect into equipment selection, quantities, proposal qualifications and test documentation.
  • sequence of operation: verify the value, units and source; reproduce the check; compare it with the applicable limit; and trace its effect into equipment selection, quantities, proposal qualifications and test documentation.
  • Shared infrastructure: name the owner of rooms, racks, pathways, network, power, UPS, grounding, firestopping, accounts, licenses and support.
  • Revision: confirm the customer-facing proposal cites the same drawing and schedule revision used for quantities.
  • Boundary: distinguish contractor coordination from engineering, permitting, code review, cybersecurity, privacy, accessibility and authority approval.
  • Acceptance: describe what will be observed, measured, demonstrated, documented and approved—not only that equipment will be installed.

If any answer is missing, assign it. A named open item is manageable; an invisible assumption is not. Use alternates when the customer must choose between documented approaches, allowances when quantity or condition cannot yet be verified, and exclusions only when the boundary is explicit and commercially understood.

Turn the answer into customer-readable scope

A professional proposal should cite the project and revision, summarize the outcome, list included deliverables, explain major quantities, identify infrastructure and third-party dependencies, state assumptions, distinguish owner-furnished items, and define tests and closeout. It should not paste this article or bury technical uncertainty in fine print.

Write inclusions around work products: survey verification, plan updates, equipment and accessory schedules, cable and pathway scope, configuration, programming, testing, training, as-builts and support. Write exclusions around clear responsibility boundaries. If a dependency could stop the system from working—such as internet, VLANs, door hardware, power, structure, permits or manufacturer services—place it near the related scope and assign an owner.

Continue through the Building Automation & Controls topic cluster

This page answers one focused question. Use the connected resources to move from the immediate answer into the complete design, documentation and commercial workflow.

Authoritative references and verification boundary

Use current editions, adopted requirements, approved submittals and exact manufacturer instructions for the actual project. The sources below provide useful primary context, but no public article can decide project-specific licensing, engineering responsibility, code compliance, cybersecurity, privacy, accessibility, product compatibility or authority acceptance.

  1. ASHRAE Standards and Guidelines — building systems and controls standards context.
  2. CISA Building Automation Systems — industrial and building controls cybersecurity context.
  3. NIST Cybersecurity Framework — cybersecurity risk management context.

Frequently asked questions

What is the fastest reliable way to start building automation points list?

Start by writing the operating outcome and collecting the evidence that controls it. Build the IDs and schedule before drawing anonymous symbols. Mark every important input as verified, selected, assumed, excluded or assigned, then connect it to a plan, relationship diagram, quantity and acceptance check.

What should be included in the project record?

At minimum, preserve the verified baseline, stable identities, the six decision groups on this page, shared infrastructure and responsibilities, product-specific requirements, quantity basis, revision status, test evidence and closeout updates. The exact set depends on the contract, system risk and responsible designer.

Can a generic rule of thumb replace manufacturer or code requirements?

No. Rules of thumb may help compare early options, but final decisions must use the adopted requirements, approved equipment data, actual route or geometry, responsible professional review and authority process that apply to the project.

How should this answer affect a proposal?

Turn unresolved facts into named qualifications rather than hidden risk. Include the controlling drawing revision, traceable quantities, responsibilities, prerequisites, allowances, alternatives, exclusions, testing and acceptance. When the design changes, issue the quantity and commercial impact together.

What should I read next?

Open BACnet Network Topology: IP, MS/TP, Routers, VLANs and Ownership for the paired industry problem, then use the canonical Building Automation & Controls workflow page to connect the answer to a complete plan, proposal and field handoff.
